ITD and regional partners are studying an additional Snake River Canyon crossing to improve safety, reduce congestion, and support agricultural and manufacturing freight.

Snake River Crossing Study

ITD and regional partners are studying an additional Snake River Canyon crossing to improve safety, reduce congestion, and support agricultural and manufacturing freight.


Overview

In 2022, ITD renewed efforts with local partners to address growing traffic and regional connectivity challenges in the Magic Valley, including a feasibility study to identify and evaluate feasible, buildable, and fundable bridge alternatives.

The study area includes a portion of the Magic Valley, a rapidly growing region where transportation improvements are critical for safety, mobility, and economic development.

Perrine Bridge with kayakers

Work Completed So Far

To date, the study team has completed the following activities:

  • Developed and evaluated potential crossing alternatives
  • Goal setting for potential improvements
  • Collected and analyzed current and future transportation data
  • Analyzed traffic patterns, including where people are traveling to and from
  • Conducted stakeholder outreach through interviews and working groups
  • Hosted two public open houses in summer 2025 to share study findings and gather initial feedback

Next Steps: Funded Initiatives

As a result of the study findings, the Idaho Transportation Board has approved funding to advance three initiatives:

  • US-93/Blue Lakes Blvd./Pole Line Rd. Intersection Improvements including analysis, a value engineering study, and preliminary planning
  • SH-50/SH-30 Corridor Planning (Red Cap Corner to I-84) including widening or replacement of the Hansen Bridge
  • Continued Snake River Crossing Study focused on advancing toward environmental review (NEPA) and securing federal funding for a potential new crossing

Each initiative will proceed independently starting in 2025. The Snake River Crossing Study will continue with an emphasis on building regional consensus for a potential third river crossing.

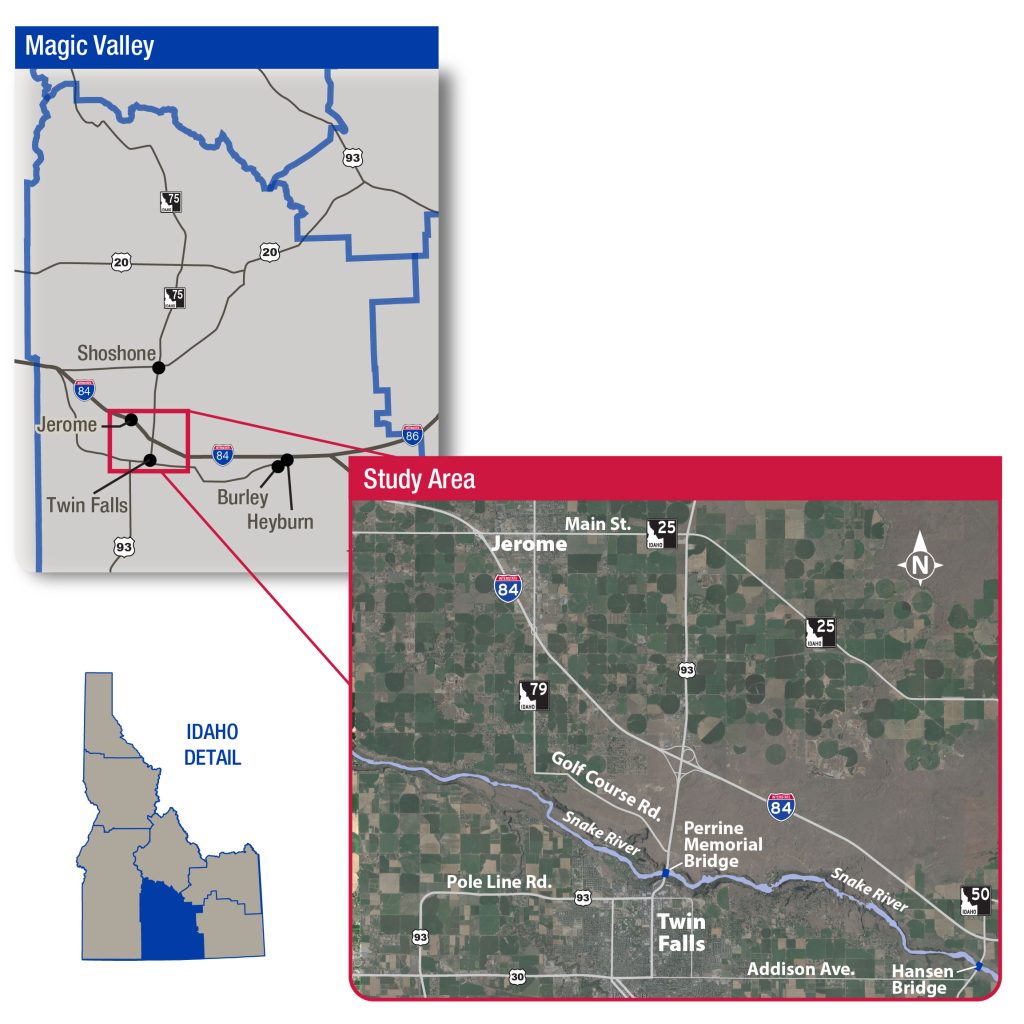

A map of Idaho with an inset of the Magic Valley. The Perrine and Hansen Bridges over the Snake River are highlighted.

Community Involvement

Early in the study, ITD worked with local jurisdictions and stakeholders across the Magic Valley to better understand transportation needs and identify potential improvements.

Public engagement has remained a key part of the process. Public meetings were held in June and August 2025 to share findings, present initial concepts, and gather feedback on project goals for a potential new crossing. These meetings had a combined 481 in-person participants, 4,596 online participants, and 344 comments received.

Public involvement will continue as the project moves into the environmental review phase. ITD will host additional public meetings and hearings at key milestones throughout the NEPA process.

The June and August 2025 public meeting summary is now available.

Responses to frequently asked questions are included in the summary document and the Frequently Asked Questions section of this site.


Timeline

  • 2022

    ITD begins US-93 Snake River Bridge Feasibility Study.

  • 2024

    Idaho Transportation Board approves funding to advance three separate initiatives resulting from the feasibility study.

  • Summer 2025

    ITD hosts public meetings to share study findings, present initial concepts, and gather feedback.

  • Early 2026

    ITD begins meeting with resource agencies and prepares the project to advance to environmental review.

  • Mid 2026

    ITD plans to work with the Federal Highway Administration (FHWA) to issue the Notice of Intent, formally initiating the NEPA process, anticipated to begin by mid-2026.

  • Future Phases

    Design and construction phases have not been established and are not currently funded.
