A Planning and Environmental Linkages study is nearing completion that will greatly aid the NEPA process that must come first before large-scale improvements can be made to US-20 from Ashton to SH-87.

US-20 Ashton to SH-87 Junction PEL Study

A Planning and Environmental Linkages study is nearing completion that will greatly aid the NEPA process that must come first before large-scale improvements can be made to US-20 from Ashton to SH-87.


Good to Know...

This study is looking ahead to the year 2050 and beyond. Construction is not currently funded and would be done in parts, over time based on the greatest safety concerns when funds are available. The Idaho Transportation Department proposes expanding to four lanes with interchanges or wide medians throughout the corridor, with specific improvements varying by location and more details given within this site.

Overview

Improvements have consistently been made over time to U.S. Highway 20 from Ashton to the junction of State Highway 87 near the Montana border. Recommendations of older studies and concerns heard from the public have been put into place—things like passing lanes, traffic signals, tree removal, rumble strips and more. Passing lanes through this Island Park corridor of US-20 give some options to help with safety now, but they won’t be enough in the future. Studied improvements will only be implemented after further environmental analysis, and if or when predicted growth and traffic projections are closer to becoming reality.

US-20 roadway and access to a local business in Last Chance near the Henry's Fork of the Snake River in the Island Park corridor, Idaho.

US-20 Island Park Corridor Planning and Environmental Linkages Study

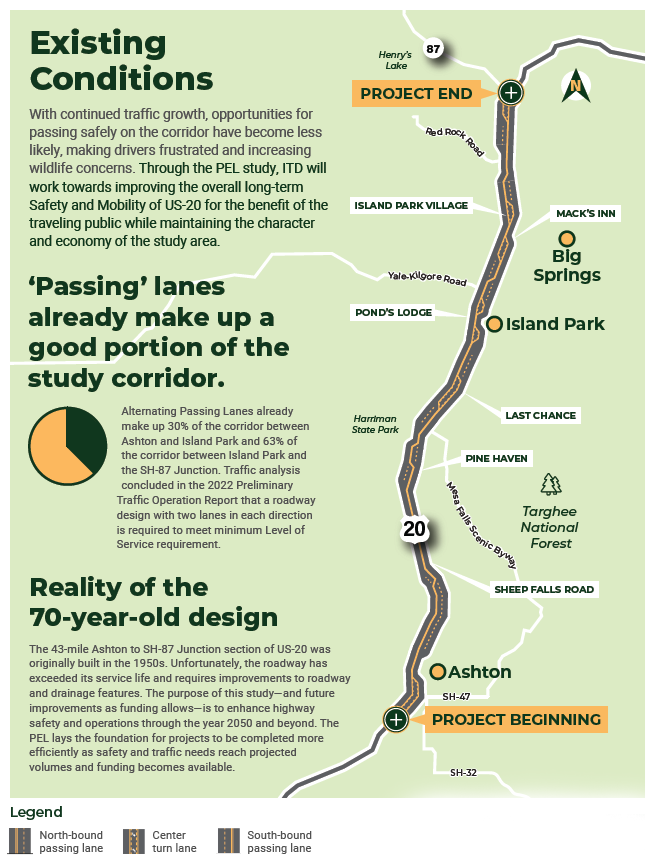

An infographic detailing the existing conditions, passing lanes and aging roadway of US-20 from Ashton to SH-87, Idaho.

If we didn’t plan for the future, what would it look like?

Generations before us studied and laid the groundwork for Idaho’s roads to handle growth and be what they are now. It’s time for us to do the same for future generations through the Island Park corridor of U.S. Highway 20.

Passing lanes from Ashton to State Highway 87 near the Montana border give some options to help with safety now, but they won’t be enough in the future.

This study’s proposed improvements do vary by location, and the Idaho Transportation Department proposes expanding to four lanes with interchanges or wide medians throughout the corridor.

This will only be implemented after further environmental analysis, and if or when predicted growth and traffic projections are closer to becoming reality. The US-20 Ashton to SH-87 Preliminary and Environmental Linkages (PEL) study is looking ahead to the year 2050 and beyond. Construction is not currently funded and would be done in parts, over time based on the greatest safety concerns when funds are available.

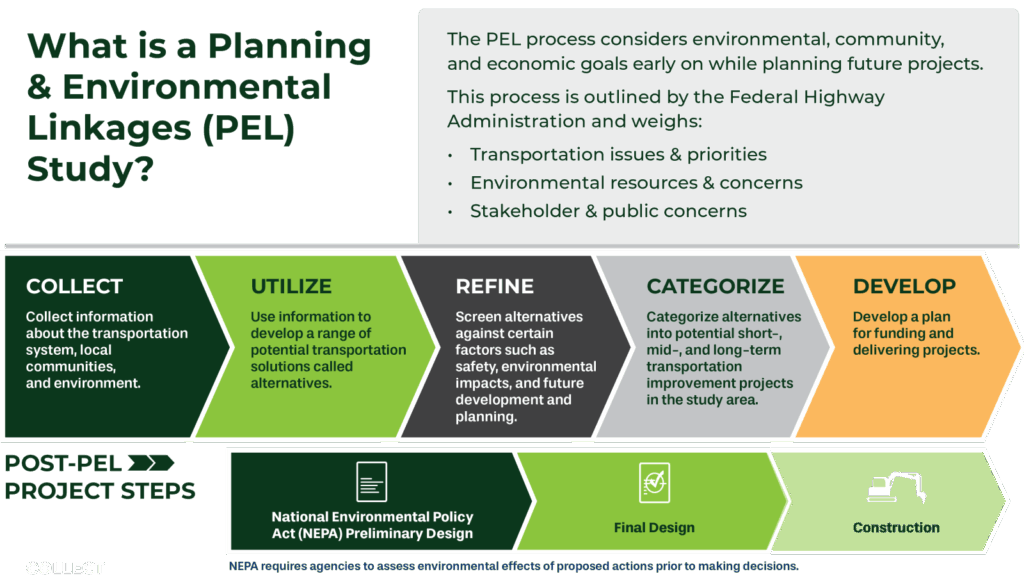

An infographic detailing what a Planning and Environmental Linkage study is and the process followed prior to NEPA.

A PEL study starts before the steps of the federally required National Environmental Policy Act (NEPA) begin. It’s intended to help make the time involved in environmental planning as efficient as possible. For any project that ITD undertakes from large to small, NEPA guidelines must be followed. Larger scale projects have a greater impact on the surrounding area and involve more NEPA documentation, coordination, effort and time. During a PEL, alternatives are looked at in detail and screened to find the ones that should be moved forward for even further consideration in the official NEPA process. Public input is a big part of a PEL study and helps us know how we can make the project what it needs to be to serve Idaho.

The US-20 Ashton to SH-87 PEL is studying the 40-mile corridor through Island Park. Because this is a long stretch of roadway, it’s been broken into sections, or “reaches” based on the geography of the area. Nine different reaches are part of this PEL, click on each to learn more:

The study’s proposed improvements do vary by location, and the Idaho Transportation Department proposes expanding to four lanes with interchanges or wide medians throughout the corridor.

The roadway and local approach of US-20 near the Henry's Fork of the Snake River in the Island Park corridor, Idaho.
The snowy roadway of US-20 through the Island Park corridor of Idaho in winter.

Timeline

  • 2016

    Updated existing Island Park Corridor Plan

  • 2019

    Three projects conducted to improve Island Park corridor, including hazardous tree removal, rumble strips and road widening

  • 2021

    Initiated and officially began the Preliminary Environmental Linkages study



    October- First public meeting



    December- Alternatives Workshops with stakeholders (local leaders, business and landowners). 59 Alternatives suggested and studied thanks to these meetings



    December to February 2022- Level one screening – the part of the process that refines alternatives based on safety, environmental impacts and more

  • 2022

    May- Level two screening



    June- Public meeting held

  • 2023

    August- Public meeting held and first Level three screening conducted



    2023 to mid 2024- Focus on increased public outreach to better understand concerns of the Ashton, Island Park and Fremont County areas. ITD attended many meetings and made contacts with leaders, business owners, community groups and anyone interested in or potentially affected by proposed future improvements to US-20.

  • 2024

    June- Additional level three screening conducted, alternatives screened against purpose and need, and viability for each of the nine reaches of the PEL study



    August- Public meetings held in Ashton and Island Park

  • 2025-2026

    March 2025- Design plans for suggested interim safety project to install a traffic signal at Elk Creek, the intersection of US-20 and Yale-Kilgore Road, finalized. Installation/ construction expected in the spring of 2026.



    2026- Final PEL study document expected to be complete

  • Future Outlook- 2050 and beyond

    Design and construction has not been funded on any of the alternatives that are involved in the PEL study, which is focused on data and growth projections for the year 2050 and beyond. The improvements being carried forward to be further studied during the NEPA process will not be constructed until deemed necessary based on those projections becoming reality. The PEL efforts now allow us to be ready when they do. All alternatives studied could potentially be further considered through the NEPA process in the future.

Purpose and Need

An infographic detailing the purpose and need, as well as goals of the US-20 Ashton to SH-87 project in Idaho.
Cars travelling on the current two-lane highway of US-20 in the Island Park, Idaho area.

Frequently Asked Questions

Contact

Project Manager Gregg Bowman (208) 745-5321 or gregg.bowman@itd.idaho.gov
